Status of Land in Trinidad and Tobago: how to check a parcel
A Status of Land enquiry gives you a written planning starting point for a particular parcel. Use it early when buying agricultural land, checking an old subdivision or investigating a proposed house.
Read the complete land conversion guideAsk about the exact parcel
Identify the lot, full location and parent parcel. Use a plan with legible boundaries and references. If several plots have similar descriptions, ask the surveyor to explain which one the deed and previous approvals cover.
A useful enquiry sets out the intended use and supplies the available planning reference numbers. Keep a copy of each document sent. This makes follow-up questions easier to answer.
Prepare the two core documents
TCPD’s published checklist identifies a deed and a cadastral sheet or survey plan for Status of Land correspondence. The applicant user guide also identifies a Certificate of Title. Check the live service checklist for any additional requirement affecting your file.
If you have only a receipt, an old lease or incomplete title records, ask TCPD what it will accept for this enquiry and ask your attorney to address the underlying ownership issue.

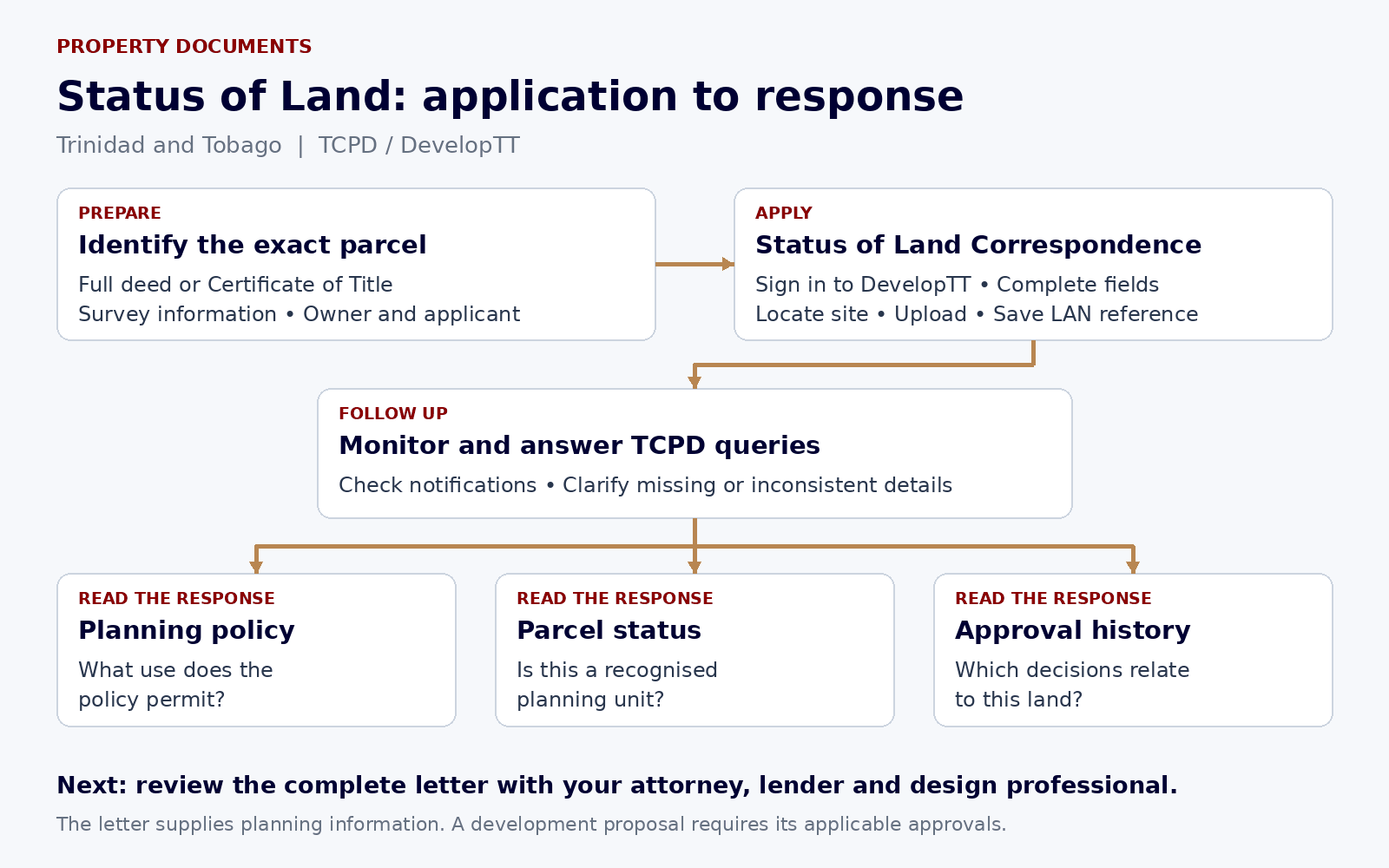

Submit the enquiry on DevelopTT
Use the Status of Land Correspondence service. Complete the location and applicant information, upload the relevant documents, review the summary and retain the acknowledgement. Monitor the application for queries.
The service listing shows 21 processing days. Record the actual submission date and any outstanding request. Ask the office about a delayed file using its reference number.
Read the response alongside the previous approvals
Check the land-use policy, parcel status and available planning history. Obtain the relevant approved layout and decision conditions where a previous approval exists. Ask TCPD to clarify any difference between the plot offered for sale and the plot shown in its records.
The Public Application Register provides an initial search route. TCPD’s regional office holds historic application information outside the online record. Keep enquiries on the smaller plot and the parent parcel linked.
| Finding | Next enquiry |
|---|---|
| Agricultural land-use policy | What application is appropriate for the proposed residential use? |
| Earlier approval mentioned | Which approved plan and conditions cover this parcel? |
| Unclear plot creation | What evidence of subdivision or historic plot status is required? |
| Outstanding technical conditions | Which office must clear each condition? |
| Mismatch in area or location | Does the surveyor need to resolve the parcel identity? |
What does an established or bonafide plot mean?
TCPD Guideline 3 recognises plots existing before August 1969 and describes its treatment of plots existing between 1969 and 1972. Evidence such as the deed, survey and assessment history matters. Have TCPD determine the position for the particular parcel.
Historic plot status concerns the creation of the plot. A new house or a proposed change in use still requires its own planning assessment. Keep the plot-history question separate in your checklist so it receives a clear answer.
Use the result before making a commitment
Give the response to the attorney and the design adviser. Ask whether it supports the proposed purchase or whether a further application, search or written clarification is needed. Have the attorney address any approval condition in the sale agreement before you commit funds.
